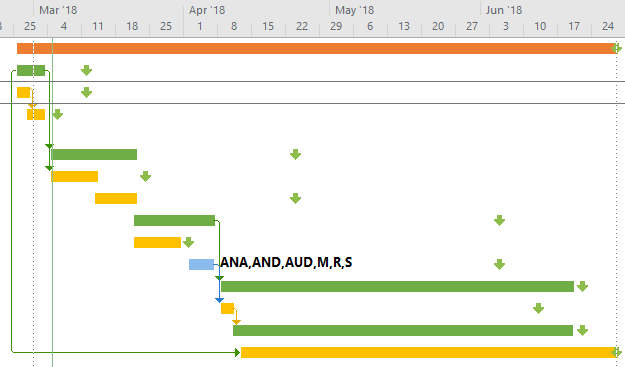

| Task | Responsible | Involved |
| Research | Audrey, Szymon, Mile and Anastasia | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Technical Research | Szymon and Mile | Andres, Mile, Rodrigo and Szymon |
| Marketing Research | Audrey | Audrey and Mile |
| Design Research | Audrey | Andres, Audrey, Rodrigo and Szymon |
| Ethical Research | Anastasia | Anastasia |
| Sustainability Research | Anastasia | Anastasia |
| Task identification & Problem Definition | Mile and Audrey | Andres, Audrey , Mile, Rodrigo and Szymon |
| Roles and Division | Mile and Szymon | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Gantt | Mile | Audrey and Mile |
| Schematics | Anastasia, Andres, Rodrigo and Szymon | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Drafts | Rodrigo and Szymon | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| 3D Drafts | Rodrigo | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Draft ethics | Anastasia | Anastasia |
| Materials | Audrey | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| List | Audrey | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Providers | Audrey | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Assembly | Andres, Mile, Rodrigo and Szymon | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| System Design | Andres, Mile, Rodrigo and Szymon | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Building the Mechanics | Rodrigo | Rodrigo |
| Building the Electronics | Andres and Szymon | Andres and Szymon |
| Programming the Electronics | Mile and Szymon | Andres, Mile and Szymon |
| Programming the Application | Mile and Szymon | Mile and Szymon |
| Testing | Andres, Mile, Rodrigo and Szymon | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Communication | Anastasia, Audrey and Mile | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Flyer | Anastasia and Audrey | Anastasia and Audrey |
| Wiki | Mile | Mile |
| Video | Mile | Mile |
| Report | Audrey | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Manual | Audrey | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| PPT | Audrey | Audrey and Szymon |
| Interim Presentation | Anastasia, Audrey and Szymon | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Content | Anastasia, Audrey and Szymon | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Visuals | Audrey and Szymon | Audrey and Szymon |
| Execution | Anastasia and Szymon | Anastasia and Szymon |
| Refined Interim Presentation | Anastasia, Audrey and Szymon | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Content | Anastasia, Audrey and Szymon | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Visuals | Audrey and Szymon | Audrey and Szymon |
| Execution | Anastasia and Szymon | Anastasia and Szymon |
| Final Report | Anastasia, Audrey and Szymon | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Content | Anastasia, Audrey and Szymon | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
| Visuals | Audrey and Szymon | Audrey and Szymon |
| Execution | Anastasia and Szymon | Anastasia and Szymon |
| Wiki Presentation | Mile | Mile |
| Video to Wiki | Mile | Mile |
| Poster to Wiki | Mile | Mile |
| Paper to Wiki | Mile | Mile |
| Manual to Wiki | Mile | Mile |
| Final Presentation | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon | Anastasia, Andres, Audrey, Mile, Rodrigo and Szymon |
